Library Retrofit, Renovation and Expansion
The Palm Springs Public Library Renovation Project
OVERVIEW
The Palm Springs Public Library, at 300 S. Sunrise Way, opened in 1975. In need of upgrades, the City applied for and was awarded $6.5 million in matching grant funds by the California State Library Grant Program for the Palm Springs Public Library Renovation Project. The grant funds and matching Measure J funding will provide maintenance and infrastructure updates to the aging building. The City has hired Group 4 Architecture + Research, Inc. from South San Francisco, CA. During the next few months, we will work with them on the design phase of this renovation project. The architects and engineers will evaluate our buildings, make design recommendations, and create various designs from which we can choose.
To begin the process, community input was solicited and October was an information-gathering month for the architectural firm. They brought engineers to the Library to look at our systems and they conducted a Community Open House as well as launched a survey. From our side, we sent them statistics and details about our current collection, programs, and services.
On Wednesday, October 25 during lunchtime, the Architects first took the information downtown at the Welwood Murray Memorial Library and received input from 60 people, representing both residents and visitors. Then our Community Open House at the main library happened on a very busy day when we were hosting several events including a children’s Halloween and Día de los Muertos program, open play Mah Jong, teen pumpkin carving, and an author event. The architects set up vision boards and gave participants dots to place on areas they thought were important. Different colored dots notated the difference between children’s input and that from adults. They were able to gather input from 152 people at the Library.
Prior to this, and continuing through November 5, we launched an online survey, in English and Spanish, asking the community to give input on their priorities for a renovated library. Paper surveys were also available at several locations throughout the City if no computer access was available. We received 595 online responses and 13 paper responses. The Architects are analyzing that input, in addition to other factors to create program options and cost estimates to present to the Library Board of Trustees, the Library Foundation and the City Council by January 2024 to decide what can be funded and what is outside the scope of our Infrastructure Grant. The timeline is aggressive with the grant funded work needing to be complete by March 2026 but we anticipate an exciting process. More to come soon as the project evolves!
The Palm Springs Public Library Renovation Project Update to City Council Thursday, April 25, 2024
Group 4 Architecture, Research + Planning, Principal, David Schnee presented a project update to City Council tonight at the Thursday, April 25 City Council meeting. A summary of the second round of community input meetings and online survey conducted in March and April 2024 will be discussed and the impact to the design direction for interiors and landscape designs will be shown, based on that community input. The PowerPoint to be shared at the City Council meeting has been uploaded here so you can see our progress.
LIBRARY RENOVATION PROJECT TIMELINE
(ALL DATES TENTATIVE)
DATES | ACTION |
APRIL 23, 2025 | CITY COUNCIL AUTHORIZES CONSTRUCTION BID REQUEST |
MAY 28, 2025 | CITY COUNCIL HOLDS PUBLIC HEARING FOR BOND HEARING |
MAY 28, 2025 JUNE 6 (ACTUAL) | CONSTRUCTION BIDS OPENED, DATE EXTENDED A WEEK |
JUNE 11, 2025 | CITY COUNCIL APPROVES 3-YEAR LEASE AGREEMENT FOR TEMPORARY LIBRARY LOCATION AT RIMROCK PLAZA |
JUNE 18, 2025 | CITY AWARDS SALE OF BONDS |
JULY 9, 2025 | CITY TO AWARD CONSTRUCTION BID |
JULY 19, 2025 | PUBLIC CLOSING PARTY |
JULY 21-31, 2025 | LIBRARY MOVES TO TEMPORARY LOCATION ALL LIBRARIES CLOSED |
AUGUST 1, 2025 | TEMPORARY LOCATION OPENS |

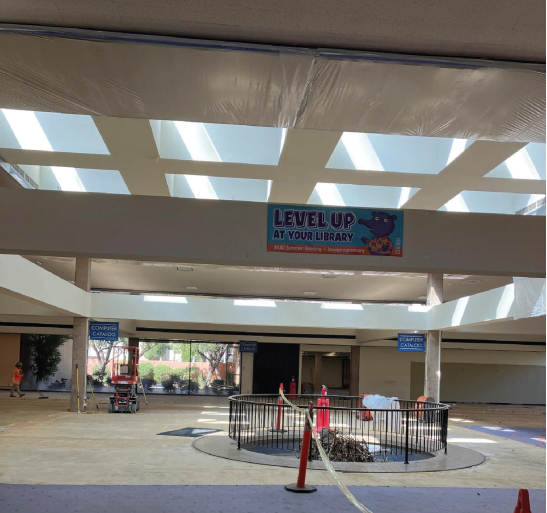

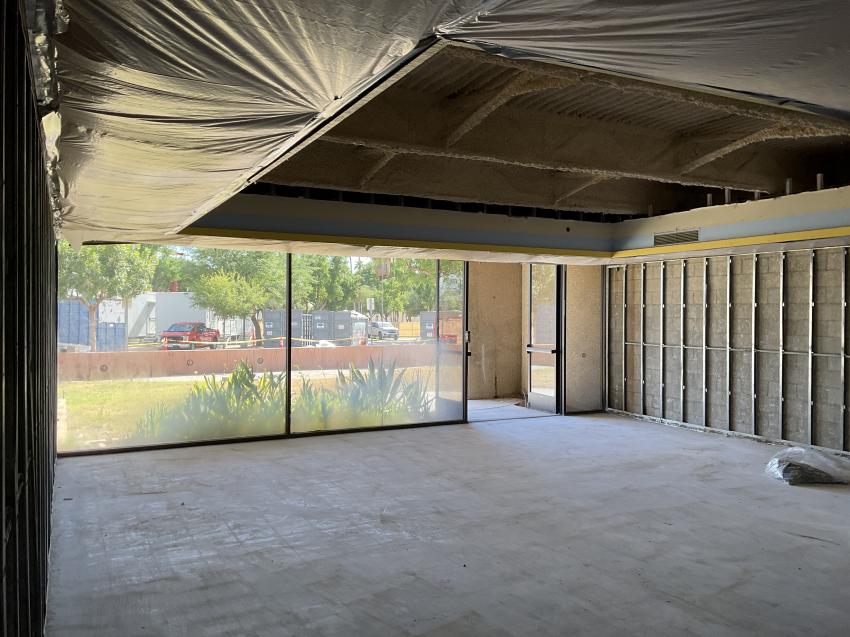

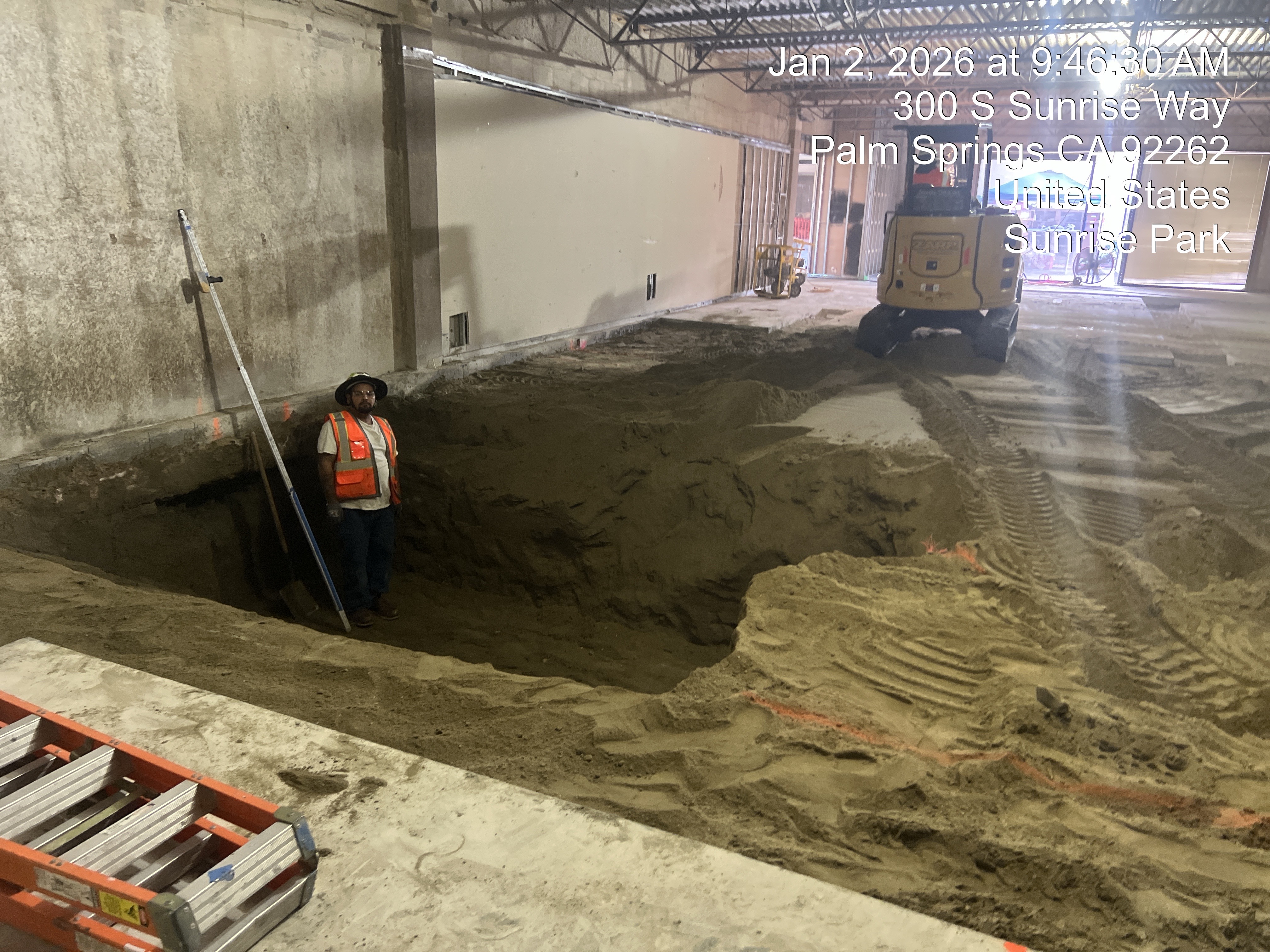

AUGUST 2025 | 18-MONTH CONSTRUCTION BEGINS GROUNDBREAKING |
FEBRUARY 2027 | CONSTRUCTION END DATE |
MARCH – MAY 2027 | CONSTRUCTION CLOSE-OUT |
SUMMER 2027 | TENTATIVE REOPENING |
THE TIMELINE DEPENDS ON THE CONSTRUCTION SCHEDULE, SUPPLY CHAIN, AND OTHER FACTORS BEYOND OUR CONTROL.
City Council Approves Lease for Library Temporary Location During Renovation
At the Wednesday, June 11th City Council meeting the Council approved the three-year lease agreement with Rimrock LLC for a 6,001 square foot storefront for the Palm Springs Public Library to use as a temporary location for library services during the upcoming renovation.
According to the current timeline, the main Library will be open through Saturday, July 19, 2025 and then will close in preparation for the upcoming renovation, slated to take anywhere from 18 to 36 months.
During this time at the temporary location, located at Rimrock Plaza on the corner of E. Palm Canyon Drive and Gene Autry Trail at 4721 E. Palm Canyon Drive, Ste. A-E, Palm Springs, CA 92262, the Library will maintain the same hours of operation Monday through Saturday. The Library will have a capsule collection of select materials in addition to the new items that come in almost daily, available to check out. Plus, there will be public computers, baby and toddler story times, Teen S.T.E.A.M. events, Passport Acceptance Services by appointment, as well as the Friends of the Library will continue to sell gently used books at the library’s temporary location. These services are in addition to the digital services offered including eBooks, downloadable music, e-Magazines, streaming television and movies, language learning, and more! Adult programs will also continue at various locations throughout the city, including at the Welwood Murray Memorial Library, located in downtown Palm Springs at 100 S. Palm Canyon Drive.
This was another important step that the Council took to keep the Library renovation project on track. Another was at the May 28th meeting when they approved the issuance of approximately $40 million in lease revenue bonds to fund major renovations within the city; $30 million of which is earmarked for the Library. The next step is reviewing the bids that were received on Friday, June 6, and after negotiations, to award the bid in mid-July.
